Welcome to the I-70 East Environmental Impact Statement (EIS) project website! En Español – La página de internet del IIA de la I-70 Este está en línea en Español
Home
New Info
Meeting Notices
Meeting Minutes
Project Overview
Project Map
Schedule
Process
Alternatives
Letters of Support
Visualization and Animation
Purchase and Relocation
Community Outreach
Environmental and Mitigation
Section 4(f) Regulations
Reports
Reports - Record of Decision (ROD)
Consultants and Contractors
Project Finance
Contact Us
Feedback Form
Media
Newsletters
FAQs
Glossary
Links
Archives
Looking for information about the Purchase and Relocation (ROW) process - click here
Read the latest Online Notice

Schedule

Printable PDF Version - click for a printable PDF version of the I-70 East EIS Schedule

View Printable PDF.
Adobe Reader: Desktop | Mobile

The I-70 East Corridor EIS was initiated in 2003. The current phase, which follows the development and release of the Supplemental Draft EIS (SDEIS) document, is found below. See the Process page for more information on major project milestones.

Click & drag to pan the
I-70 East EIS Schedule:

2003 - Oct. 2010 (click to view)

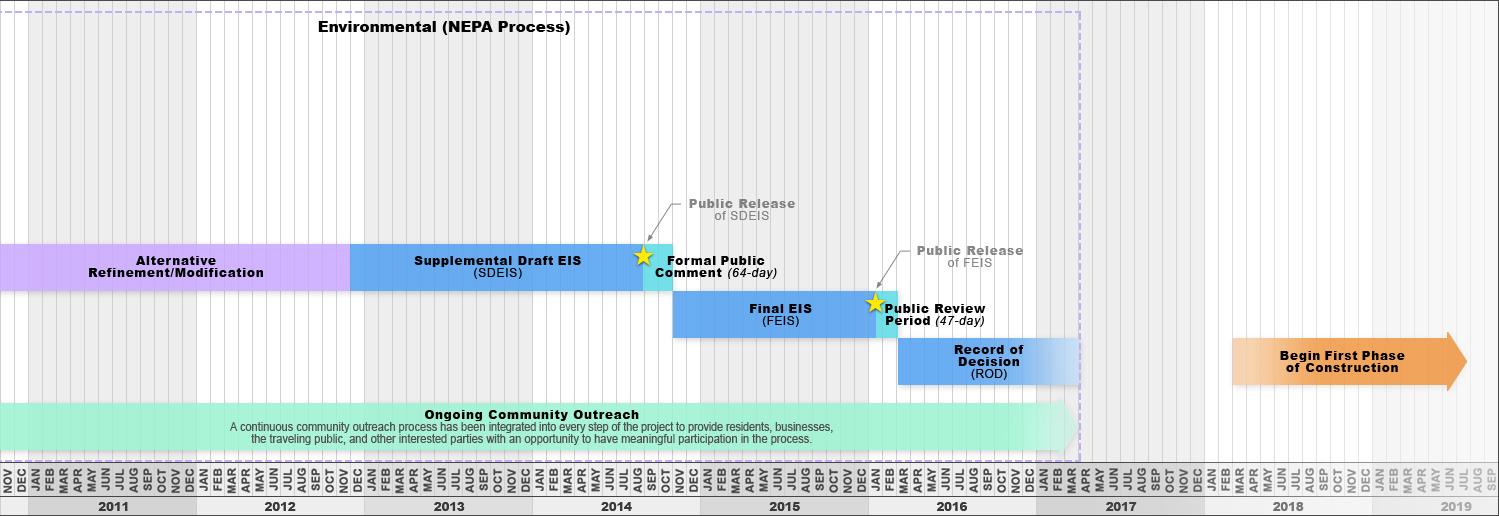

Nov. 2010 - 2019

Click and drag to pan the I-70 East EIS schedule graphic (November 2010 through 2019)

Schedule graphic last updated: September 2016
